Describe the techniques for estimating time



Describe the techniques for estimating time



Answers


Francis
1. System Analogy
- bases a current work package time estimate on the actual time of a work package from a similar project already completed
- Usually done in a “Top-down” approach
- Have 3 or 4 experts review requirements
- Make sure you have the experience and that the two systems are very similar
- Can use time, or LOC, or Function Points

Package-Level or Bottom-Up Analogy
- Involves estimating individual work activities and summing them to get a project total
- Each person assigned to that work activity, does the estimate
- Can be time intensive to develop
- Dependent on each individual’s ability to estimate
- Combining several independent estimates yields a better estimate than separate estimates. Errors are randomly distributed; statistically speaking


2. Three Point
- Use a weighted average approach or beta probability distribution approach to capture three point estimates for each
work package: Optimistic, Normal, Pessimistic
- Equations for expected value (E), and the standard deviation (SD) are:
E = (a + 4b + c)/6; SD = (c-a)/6
a = the optimistic estimate
b = normal estimate
c = pessimistic estimate
- Adds the element of risk into its calculations
- SME’s determine three types of estimates:
Most Likely
Optimistic
Pessimistic
- Next the SME uses the weighted average formula
Weighted average = #(8 workdays + 4 X 10 workdays + 24 workdays = 12 days)/6#
where:
optimistic time= 8 days
most likely time = 10 days
pessimistic time = 24 days
- Therefore, you’d use 12 days on the schedule instead of 10 when using this technique.

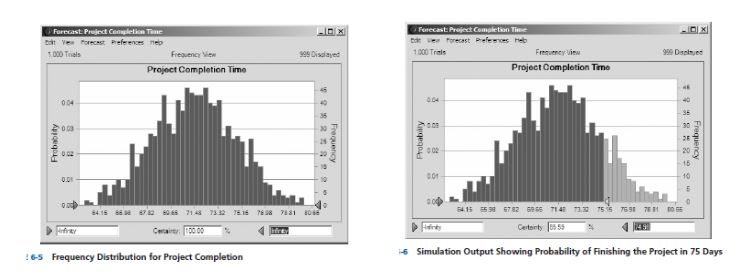

3. Simulation
- A technique that randomly generates specific end values for a variable with a specific probability distribution

Capture 6.JPG


4. COCOMO
- First developed by Barry Boehm in 1981
- Most widely accepted models available today
- Revised into version II in 1995
- Version II setup to handle new development methodologies; RAD, Iterative/Incremental, COTS packages, O-O application distribution, frameworks and components, etc.
- Models available on website and algorithms are published. Commercial software exists
- Consists of three project types described as:
(i). Organic – small project teams, little innovation, constraints and deadlines are few, stable development environments,
known familiar technology, few changes expected
(ii). Semidetached – medium sized project teams, some innovation, few constraints, tighter deadlines, and more changes
expected, still a fairly stable development environment
(iii). Embedded – largest of the three in all categories, large project teams, constant innovation, many constraints, very tight deadlines, and many changes expected, complex development environment.
